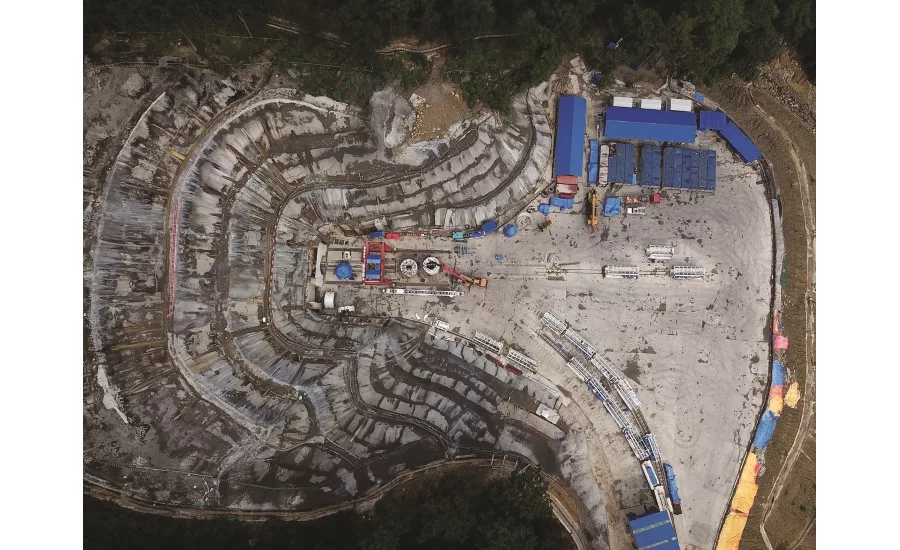

Nepal’s first tunnel boring machine, a 16.6-foot-diameter Robbins Double Shield, is living up to the nation’s high expectations. The TBM, supplied in summer 2017 for the Bheri Babai Diversion Multipurpose Project (BBDMP), recently bored over 3,280 feet in one month and has been averaging an impressive 2,630 feet per month. The project is owned by the Government of Nepal’s Department of Irrigation (DOI) and operated by contractor China Overseas Engineering Group Co. Ltd. Nepal Branch (COVEC Nepal).
The decision to use a TBM for the BBDMP project—designated by the government as one of Nepal’s 11 National Pride Projects—was a departure for a nation where drill and blast has long been the preferred tunneling method. Early studies done on the tunnel path predicted that drill and blast excavation of the 7.5 mile tunnel would take close to 12 years to complete. The tunnel is located in the Siwalik Range, part of the southern Himalayan Mountains, where geology consists of mainly sandstone, mudstone and conglomerate.
Wang Wu Shui, general manager for COVEC Nepal, cited several factors that have contributed to the good advance rates so far. “In China, there is a proverb about TBM construction: ‘geology is the premise, equipment is the foundation and talents are the key.’ The great advance rates achieved at present mainly lie in preliminary planning, process control and professional construction personnel.”
Shui added that technical training and guidance are provided for each position so that all personnel can fully understand their job and team responsibilities. If unforeseen circumstances arise and there is no operator for a certain position, others have enough training to fill the role.
To ensure the best TBM performance and to prevent downtime, machine maintenance occurs daily at a fixed time. Geological engineers are sent to analyze the ground conditions twice daily so that construction personnel can adjust the tunneling parameters and prepare for auxiliary measures if geological changes are predicted.
The ground conditions during the record-setting month consisted mainly of sandstone and mudstone, but that is set to change. At about the 3.6-mile mark, the machine will encounter a major fault zone known as the Bheri Thrust. Clay and water ingress are expected throughout the fault, which is about 1,312- to 1,968-feet wide.
COVEC Nepal are prepared for the conditions and have worked out efficient tunneling logistics to decrease downtime. “The two working procedures of tunneling and segment erection are carried out simultaneously under the double shield tunneling mode, and the time to erect a ring of segments is 15 minutes in general,” Shui says. “Under the single shield tunneling mode, segment erection comes after tunneling in a sequential process, but the segment erection time is still about 15 minutes.”
To further reduce time, consolidation grouting is carried out in advance during daily maintenance to avoid the impact of downtime for grouting on the overall construction progress.
Once complete, the BBDMP will irrigate 60,000 hectares (or 148, 263 acres) of land in the southern region of Nepal and benefit an estimated 30,000 households. It will divert 1,400 cubic feet of water per second from the Bheri River to the Babai River under a head of 490 feet using a 49-foot-tall dam, providing year-round irrigation in the surrounding Banke and Bardia districts. The water will also be used for hydroelectricity, with a generating capacity of 48 mw benefiting the country with $20 million annually. The initial success of the TBM operation has already inspired developers and contractors to opt for TBMs over conventional excavation methods on upcoming Nepalese tunnels.
